Page 56 - pd307-Aug22-mag-web-Neat
P. 56

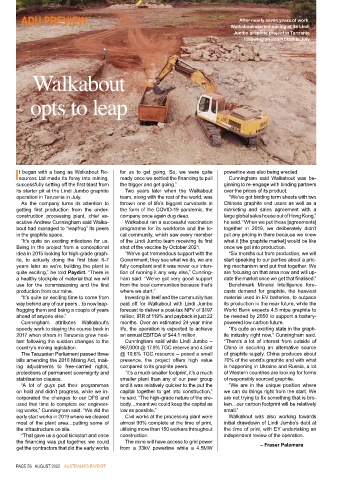

ADU PReVIeW                                                                  After nearly seven years of work,
                                                                                  Walkabout started mining at its Lindi
                                                                                   Jumbo graphite project in Tanzania
                                                                                       following an initial blast in July






             Walkabout




            opts to leap













        t began with a bang as Walkabout Re-  for us to get going. So, we were quite   powerline was also being erected.
      Isources Ltd made its foray into mining,   ready once we settled the financing to pull   Cunningham  said  Walkabout  was  be-
       successfully setting off the first blast from   the trigger and get going.”  ginning to re-engage with binding partners
       its starter pit at the Lindi Jumbo graphite   Two  years  later  when  the  Walkabout   over the prices of its product.
       operation in Tanzania in July.      team, along with the rest of the world, was   “We’ve got binding term sheets with two
        As the company turns its attention to   thrown one of life’s biggest curveballs in   Chinese graphite end users as well as a
       getting  first  production  from  the  under-  the form of the COVID-19 pandemic, the   marketing  and sales agreement with  a
       construction processing plant, chief ex-  company once again dug deep.   large global sales house out of Hong Kong,”
       ecutive Andrew Cunningham said Walka-  Walkabout ran a successful vaccination   he said. “When we put these [agreements]
       bout had managed to “leapfrog” its peers   programme for its workforce and the lo-  together in 2019, we deliberately didn’t
       in the graphite space.              cal community, which saw every member   put any pricing in there because we knew
        “It’s  quite  an  exciting  milestone  for  us.   of the Lindi Jumbo team receiving its first   what it [the graphite market] would be like
       Being in the project from a conceptional   shot of the vaccine by October 2021.  once we got into production.
       idea in 2015 looking for high-grade graph-  “We’ve got tremendous support with the   “Six months out from production, we will
       ite,  to  actually  doing  the  first  blast  6-7   Government, they see what we do, we are   start speaking to our parties about a pric-
       years later as we’re building the plant is   fully compliant and it was never our inten-  ing mechanism and put that together. We
       quite exciting,” he told Paydirt. “There is   tion of running it any way else,” Cunning-  are focusing on that area now and will up-
       a healthy stockpile of material that we will   ham said. “We’ve got very good support   date the market once we get that finalised.”
       use  for  the  commissioning  and  the  first   from the local communities because that’s   Benchmark  Mineral  Intelligence  fore-
       production from our mine.           where we start.”                     casts demand for graphite, the heaviest
        “It’s quite an exciting time to come from   Investing in itself and the community has   material used in EV batteries, to outpace
       way behind any of our peers…to now leap-  paid  off for Walkabout with  Lindi Jumbo   its production in the near future, while the
       frogging them and being a couple of years   forecast to deliver a post-tax NPV of $197   World Bank expects 4.5 mtpa graphite to
       ahead of anyone else.”              million, IRR of 119% and payback in just 22   be needed by 2050 to support a battery-
        Cunningham  attributes  Walkabout’s   months. Over an estimated 24-year mine   powered low carbon future.
       speedy work to staying the course back in   life, the operation is expected to achieve   “It’s quite an exciting state in the graph-
       2017 when others in Tanzania grew hesi-  an annual EBITDA of $44.1 million.  ite industry right now,” Cunningham said.
       tant following the sudden changes to the   Cunningham said while Lindi Jumbo –   “There’s  a  lot  of  interest  from  outside  of
       country’s mining legislation.       987,000t @ 17.9% TGC reserve and 4.5mt   China in securing an alternative source
        The Tanzanian Parliament passed three   @ 10.8% TGC resource – posed a small   of graphite supply. China produces about
       bills amending the 2010 Mining Act, mak-  presence, the project offers high value   70% of the world’s graphite and with what
       ing  adjustments  to  free-carried  rights,   compared to its graphite peers.  is happening in Ukraine and Russia, a lot
       protections of permanent sovereignty and   “It’s a much smaller footprint, it’s a much   of Western countries are looking for forms
       stabilisation clauses.              smaller plant than any of our peer group   of responsibly sourced graphite.
        “A lot of guys put their programmes   and it was relatively quicker to the put the   “We are in the unique position where
       on hold and didn’t progress, while we in-  capital  together  to get into  construction,”   we can do things right from the start. We
       corporated the changes to our DFS and   he said. “The high-grade nature of the ore-  are not trying to fix something that is bro-
       used that time to complete our engineer-  body…meant we could keep the capital as   ken…our carbon footprint will be relatively
       ing works,” Cunningham said. “We did the   low as possible.”             small.”
       early start works in 2019 where we cleared   Civil works at the processing plant were   Walkabout was also  working  towards
       most of the plant area…putting some of   almost 90% complete at the time of print,   initial drawdown of Lindi Jumbo’s debt at
       the infrastructure on site.         utilising more than 150 workers throughout   the time of print, with EY undertaking an
        “That gave us a good kickstart and once   construction.                 independent review of the operation.
       the financing was put together, we could   The mine will have access to grid power                    – Fraser Palamara
       get the contractors that did the early works   from a 33kV powerline while a 4.5MW
