B11 – First drawbell imminent
BHP’s first developed block cave
Leinster B11 is progressing the undercut phase
• The undercut and the completion of the draw-points is
expected to be completed by the end of calendar year
2022
• Ramp up will continue in 2023.
• First draw-bell firing imminent
• Seismic responses to undercutting in line with expectations
and plan
• Strong QA/QC on tunnel development and ground support
installation was a key element of ground control measures
• Caving when commenced is expected to break-through
into the old sub level cave after 2-3 years

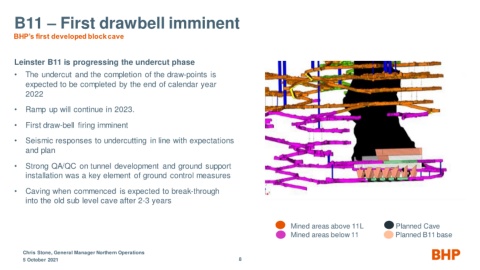

Mined areas above 11L Planned Cave
Mined areas below 11 Planned B11 base
Chris Stone, General Manager Northern Operations
5 October 2021 8
