                  Tietto keeps Abujar turning





                      by Michael Washbourne




              s Tietto Minerals Ltd prepares to become West Africa’s
          Anewest gold producer, founder and managing director
          Caigen Wang has lauded those who stuck by him and the
          company over the past 12 years.
          Tietto was set to pour first gold from its Abujar project in Cote
          d’Ivoire at the time of print, completing one of the most rapid
          transitions from explorer to producer in recent years.
          For Wang, it has been a remarkable journey since the
          company’s inception in 2010 as an iron ore explorer in Liberia.
          Tietto  crossed  over  to  Cote  d’Ivoire  four  years  later  before
          listing on the ASX in 2018 and hasn’t looked back since.
          Speaking to  GMJ from Abujar where he was readying for

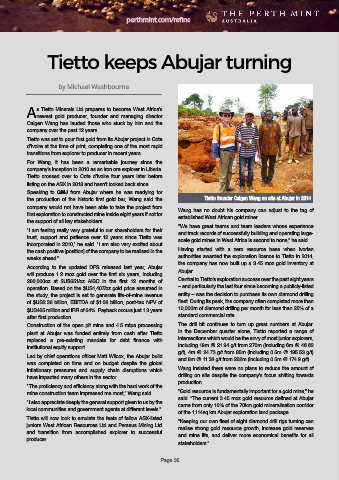

                                                                        Tietto founder Caigen Wang on site at Abujar in 2014
          the  production  of  the  historic  first  gold  bar,  Wang  said  the
          company would not have been able to take the project from
                                                               Wang has no doubt his company can adjust to the tag of
          first exploration to constructed mine inside eight years if not for
                                                               established West African gold miner.
          the support of all key stakeholders.
                                                               “We have great teams and team leaders whose experience
          “I am feeling really very grateful to our shareholders for their
                                                               and track records of successfully building and operating large-
          trust, support and patience over 12 years since Tietto was
                                                               scale gold mines in West Africa is second to none,” he said.
          incorporated in 2010,” he said. “I am also very excited about
                                                               Having  started  with  a  zero  resource  base  when  Ivorian
          the cash positive [position] of the company to be realised in the
          weeks ahead.”                                        authorities awarded the exploration licence to Tietto in 2014,
                                                               the company has now built up a 3.45 moz gold inventory at
          According to the updated DFS released last year, Abujar
                                                               Abujar.
          will produce 1.2 moz gold over the first six years, including
                                                               Central to Tietto’s exploration success over the past eight years
          260,000oz  at  $US651/oz  AISC  in  the  first  12  months  of
          operation. Based on the $US1,407/oz gold price assumed in   – and particularly the last four since becoming a publicly-listed
                                                               entity – was the decision to purchase its own diamond drilling
          the study, the project is set to generate life-of-mine revenue
          of $US2.38 billion, EBITDA of $1.08 billion, post-tax NPV of   fleet. During its peak, the company often completed more than
                                                               10,000m of diamond drilling per month for less than 25% of a
          $US465 million and IRR of 64%. Payback occurs just 1.3 years
          after first production.                              standard commercial rate.
          Construction of the open pit mine and 4.5 mtpa processing   The drill bit continues  to turn  up great numbers at  Abujar.
                                                               In  the  December  quarter  alone,  Tietto  reported  a  range  of
          plant at Abujar was funded entirely from cash after Tietto
          replaced  a  pre-existing  mandate  for  debt  finance  with   intersections which would be the envy of most junior explorers,
                                                               including 19m @ 21.94 g/t from 270m (including 6m @ 46.62
          institutional equity support.
                                                               g/t), 4m @ 24.73 g/t from 85m (including 0.5m @ 195.53 g/t)
          Led by chief operations officer Matt Wilcox, the Abujar build
                                                               and 8m @ 11.38 g/t from 262m (including 0.5m @ 174.9 g/t).
          was  completed  on  time  and  on  budget  despite  the  global
          inflationary  pressures  and  supply  chain  disruptions  which   Wang insisted there were no plans to reduce the amount of
                                                               drilling on site despite the company’s focus shifting towards
          have impacted many others in the sector.
                                                               production.
          “The proficiency and efficiency along with the hard work of the
                                                               “Gold resource is fundamentally important for a gold mine,” he
          mine construction team impressed me most,” Wang said.
                                                               said. “The current 3.45 moz gold resource defined at Abujar
          “I also appreciate deeply the general support given to us by the
                                                               came from only 10% of the 70km gold mineralisation corridor
          local communities and government agents at different levels.”
                                                               of the 1,114sq km Abujar exploration land package.
          Tietto will now look to emulate the feats of fellow ASX-listed
                                                               “Keeping our own fleet of eight diamond drill rigs turning can
          juniors West African Resources Ltd and Perseus Mining Ltd
                                                               realise strong gold resource growth, increase gold reserves
          and transition from accomplished explorer to successful
                                                               and  mine  life,  and  deliver  more  economical  benefits  for  all
          producer.
                                                               stakeholders.”
