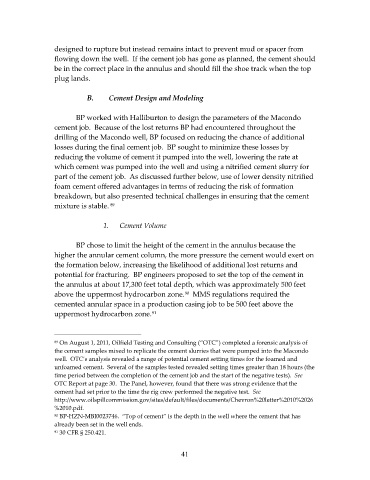

Page 46 - test2
P. 46

designed to rupture but instead remains intact to prevent mud or spacer from
                   flowing down the well.  If the cement job has gone as planned, the cement should
                   be in the correct place in the annulus and should fill the shoe track when the top
                   plug lands.

                              B.     Cement Design and Modeling


                          BP worked with Halliburton to design the parameters of the Macondo
                   cement job.  Because of the lost returns BP had encountered throughout the
                   drilling of the Macondo well, BP focused on reducing the chance of additional
                   losses during the final cement job.  BP sought to minimize these losses by
                   reducing the volume of cement it pumped into the well, lowering the rate at
                   which cement was pumped into the well and using a nitrified cement slurry for
                   part of the cement job.  As discussed further below, use of lower density nitrified
                   foam cement offered advantages in terms of reducing the risk of formation
                   breakdown, but also presented technical challenges in ensuring that the cement
                   mixture is stable.
                                      89

                                   1.    Cement Volume

                          BP chose to limit the height of the cement in the annulus because the
                   higher the annular cement column, the more pressure the cement would exert on
                   the formation below, increasing the likelihood of additional lost returns and
                   potential for fracturing.  BP engineers proposed to set the top of the cement in
                   the annulus at about 17,300 feet total depth, which was approximately 500 feet
                   above the uppermost hydrocarbon zone.   MMS regulations required the
                                                              90
                   cemented annular space in a production casing job to be 500 feet above the
                   uppermost hydrocarbon zone.
                                                   91


                   89  On August 1, 2011, Oilfield Testing and Consulting (“OTC”) completed a forensic analysis of
                   the cement samples mixed to replicate the cement slurries that were pumped into the Macondo
                   well.  OTC’s analysis revealed a range of potential cement setting times for the foamed and
                   unfoamed cement.  Several of the samples tested revealed setting times greater than 18 hours (the
                   time period between the completion of the cement job and the start of the negative tests).  See
                   OTC Report at page 30.  The Panel, however, found that there was strong evidence that the
                   cement had set prior to the time the rig crew performed the negative test.  See
                   http://www.oilspillcommission.gov/sites/default/files/documents/Chevron%20letter%2010%2026
                   %2010.pdf.
                   90  BP‐HZN‐MBI0023746.  “Top of cement” is the depth in the well where the cement that has
                   already been set in the well ends.
                   91  30 CFR § 250.421.
