Page 45 - pd279-Feb20-mag-web_Neat
P. 45

of  2020  deciding  exactly   iron and there are a few options we are   being addressed. In January, the com-
                   what that will look like.  looking to bring online. We would love to   pany announced completion of a second
                     The 2018 PFS gave a tick   partner with a company with a high sili-  2,000m RC programme in two months.
                   of approval for development   ca, alumina iron ore project that we can   “Potential  financiers  were  saying  that
                   and work since has focused   blend with our product and then sell.”  such a capex would require a long mine
                   on refining capex and opex   In addition  to improving “There have   life,” Algar said. “So, we have returned to
                   numbers to build a more ro-  been a few delays on piloting, but we   areas of the resource where previously
                   bust economic case.       want to get the piloting right,” he said.   we didn’t have the time or money to drill.
                     In October, AVL an-     “We wanted to make sure the material   Three blocks in the south-east have a
                   nounced a revised pro-    is sustainable for the entire orebody. We   combined 50mt of inferred resources so
                   cessing plan for the project   looked at the pre-feasibility studies in   we are targeting them for conversion to
                   which will see ore mined   other minerals and found that if you rush   indicated which would extend the mine
                   and beneficiated on site be-
                   fore 850,000t of material is
                   trucked  to  a  location  near
                   the  Port  of  Geraldton  for
                   back-end processing.
                     “We’ve  been  looking
                   at moving the plant since
                   January 2018. Gas has al-
                   ways been a primary driver
                   of  processing  economics
                   and leaving the plant on
                   site came with a $40 mil-
                   lion capex component. We
                   began an optimisation study
                   and said if we moved closer
                   to the Bunbury-Dampier
                   gas pipeline it would result
                   in cheaper capital costs and
                   less gas so therefore lower
                   operating costs because we
                   would be paying almost no
                   transmission fee.
                     “The  pipeline capex  is
                   now less than $15 million
         with gas costing $2-3 against $8 previ-
         ous, so it has been a big step.”
          The  exact  make-up  of  the  Geraldton
         processing plant is yet to be established
         with  AVL  continuing  to  refine  the  flow
         sheet.
          The company is pursuing a pelletis-
         ing and roasting path to production of
         primary vanadium with the most recent

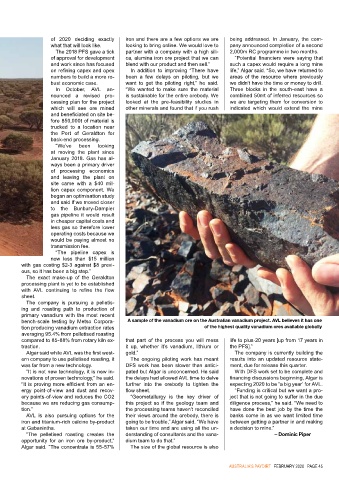

         bench-scale testing by Metso Corpora-  A sample of the vanadium ore on the Australian vanadium project. AVL believes it has one
         tion producing vanadium extraction rates                        of the highest quality vanadium ores available globally
         averaging 95.4% from pelletised roasting
         compared to 85-88% from rotary kiln ex-  that part of the process you will mess   life to plus-20 years [up from 17 years in
         traction.                           it up, whether it’s vanadium, lithium or   the PFS].”
          Algar said while AVL was the first west-  gold.”                         The company is currently building the
         ern company to use pelletised roasting, it   The  ongoing piloting work has  meant   results into an updated resource state-
         was far from a new technology.      DFS work has been slower than antici-  ment, due for release this quarter.
          “It is not new technology, it is new in-  pated but Algar is unconcerned. He said   With DFS work set to be complete and
         novations of proven technology,” he said.   the delays had allowed AVL time to delve   financing discussions beginning, Algar is
         “It is proving more efficient from an en-  further into the orebody to tighten the   expecting 2020 to be “a big year’ for AVL.
         ergy point-of-view and dust and recov-  flow sheet.                       “Funding is critical but we want a pro-
         ery points-of-view and reduces the CO2   “Geometallurgy is the key driver of   ject that is not going to suffer in the due
         because we are reducing gas consump-  this project so if the geology team and   diligence process,” he said. “We need to
         tion.”                              the processing teams haven’t reconciled   have done the best job by the time the
          AVL is also pursuing options for the   their views around the orebody, there is   banks come in as we want limited time
         iron and titanium-rich calcine by-product   going to be trouble,” Algar said. “We have   between getting a partner in and making
         at Gabanintha.                      taken our time and are using all the un-  a decision to mine.”
          “The  pelletised  roasting  creates  the   derstanding of consultants and the vana-             – Dominic Piper
         opportunity for an iron ore by-product,”   dium team to do that.”
         Algar said. “The concentrate is 55-57%   The size of the global resource is also



                                                                                  aUSTRaLIa’S PaYDIRT   FeBRUaRY 2020   Page 45
