72      SY DNEY  AREA  B Y  AREA

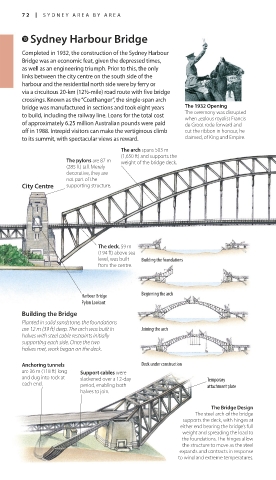

       e Sydney Harbour Bridge

       Completed in 1932, the construction of the Sydney Harbour
       Bridge was an economic feat, given the depressed times,
       as well as an engi neering triumph. Prior to this, the only
       links between the city centre on the south side of the
       harbour and the residential north side were by ferry or
       via a circuitous 20-km (12½-mile) road route with five bridge
       crossings. Known as the “Coathanger”, the single-span arch
       bridge was manufactured in sections and took eight years    The 1932 Opening
       to build, including the railway line. Loans for the total cost    The ceremony was disrupted
                                                when zealous royalist Francis
       of approximately 6.25 million Australian pounds were paid   de Groot rode forward and
       off in 1988. Intrepid visitors can make the vertiginous climb   cut the ribbon in honour, he
       to its summit, with spectacular views as reward.  claimed, of King and Empire.
                                The arch spans 503 m
                                (1,650 ft) and supports the
                  The pylons are 87 m    weight of the bridge deck.
                  (285 ft) tall. Merely
                  decorative, they are
                  not part of the
       City Centre  supporting structure.







                          The deck, 59 m
                          (194 ft) above sea
                          level, was built   Building the foundations
                          from the centre.



                      Harbour Bridge   Beginning the arch
                      Pylon Lookout
       Building the Bridge
       Planted in solid sandstone, the foundations
       are 12 m (39 ft) deep. The arch was built in   Joining the arch
       halves with steel cable restraints initially
       supporting each side. Once the two
       halves met, work began on the deck.

       Anchoring tunnels             Deck under construction
       are 36 m (118 ft) long   Support cables were
       and dug into rock at   slackened over a 12-day   Temporary
       each end.      period, enabling both           attachment plate
                      halves to join.

                                                       The Bridge Design
                                                   The steel arch of the bridge
                                                supports the deck, with hinges at
                                               either end bearing the bridge’s full
                                                weight and spreading the load to
                                                the foundations. The hinges allow
                                                the structure to move as the steel
                                               expands and contracts in response
                                               to wind and extreme temperatures.




   072-073_EW_Sydney.indd   72                              29/05/17   12:19 pm
