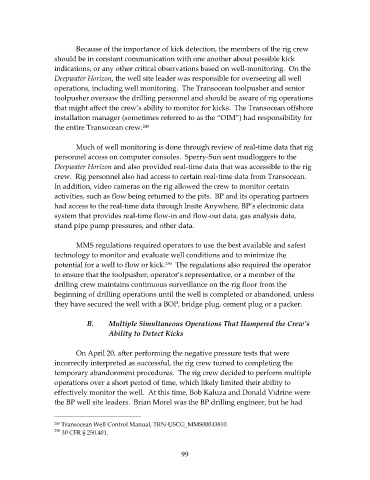

Because of the importance of kick detection, the members of the rig crew
                   should be in constant communication with one another about possible kick
                   indications, or any other critical observations based on well‐monitoring.  On the
                   Deepwater Horizon, the well site leader was responsible for overseeing all well
                   operations, including well monitoring.  The Transocean toolpusher and senior
                   toolpusher oversaw the drilling personnel and should be aware of rig operations
                   that might affect the crew’s ability to monitor for kicks.  The Transocean offshore
                   installation manager (sometimes referred to as the “OIM”) had responsibility for
                   the entire Transocean crew.
                                                249

                          Much of well monitoring is done through review of real‐time data that rig
                   personnel access on computer consoles.  Sperry‐Sun sent mudloggers to the
                   Deepwater Horizon and also provided real‐time data that was accessible to the rig
                   crew.  Rig personnel also had access to certain real‐time data from Transocean.
                   In addition, video cameras on the rig allowed the crew to monitor certain
                   activities, such as flow being returned to the pits.  BP and its operating partners
                   had access to the real‐time data through Insite Anywhere, BP’s electronic data
                   system that provides real‐time flow‐in and flow‐out data, gas analysis data,
                   stand pipe pump pressures, and other data.

                          MMS regulations required operators to use the best available and safest
                   technology to monitor and evaluate well conditions and to minimize the
                   potential for a well to flow or kick.   The regulations also required the operator
                                                        250
                   to ensure that the toolpusher, operator’s representative, or a member of the
                   drilling crew maintains continuous surveillance on the rig floor from the
                   beginning of drilling operations until the well is completed or abandoned, unless
                   they have secured the well with a BOP, bridge plug, cement plug or a packer.

                              B.     Multiple Simultaneous Operations That Hampered the Crew’s
                                     Ability to Detect Kicks

                          On April 20, after performing the negative pressure tests that were
                   incorrectly interpreted as successful, the rig crew turned to completing the
                   temporary abandonment procedures.  The rig crew decided to perform multiple
                   operations over a short period of time, which likely limited their ability to
                   effectively monitor the well.  At this time, Bob Kaluza and Donald Vidrine were
                   the BP well site leaders.  Brian Morel was the BP drilling engineer, but he had


                   249  Transocean Well Control Manual, TRN‐USCG_MMS00043810.
                   250
                      30 CFR § 250.401.
